• Skip to primary navigation
  • Skip to main content
  • Skip to primary sidebar
  • Skip to footer

Electric Power Supply Association

  • Blog
  • Podcast
  • About EPSA
    • Policy Principles
    • EPSA Members
    • Our Staff
    • Careers
  • For Members
    • Join EPSA
    • Committees
  • Contact
  • FAQ
EPSA

EPSA

  • Newsroom
    • Media Contacts
    • Press Releases
    • PowerFacts Blog
    • Factsheets and White Papers
    • Power Moves Newsletter
    • Opinion and Commentary
    • Social Media
    • Podcast
  • Policy & Advocacy
    • Policy Positions
    • Federal Energy Regulatory Commission
    • Federal
    • Judiciary
    • State
    • ISOs/RTOs
  • Power Facts
    • Rising Power Demand
    • Reliable Power
    • Energy Cost Savings
    • Environmental Progress
    • Energy Innovation
    • In Your State
  • Understanding Your Electric Bill
Home / PowerFacts Blog / 800+ Projects Enter PJM Queue, Showing Strong Competitive Power Generator Response to Reliability Needs, Energy Prices, and Data Center Growth

May 1, 2026

800+ Projects Enter PJM Queue, Showing Strong Competitive Power Generator Response to Reliability Needs, Energy Prices, and Data Center Growth

By EPSA

What PJM’s Interconnection Queue Means for the Future of Power Supply

Top takeaways:

  • More than 800 new power projects applied to connect to the grid with roughly 220 gigawatts of potential capacity signaling a strong market response to rising electricity demand.
  • A diverse mix of resources—including natural gas, storage, renewables, and emerging nuclear fusion technology—highlights both innovation and the continued need for reliable, on-demand power.
  • Bringing new generation to construction relies on clearing permitting hurdles, supply chain delays, and workforce challenges faced by developers across all regions and market models.

As electricity demand rises across the U.S., project applications for what is known as the interconnection queue are one of the first steps to getting new power supply online.

The interconnection queue is the process through which developers apply for approval to connect new power plants to the grid. Without clearing this step, no project, regardless of technology, can deliver electricity to homes, businesses, or large energy users.

In much of the Mid-Atlantic and Midwest, this process is managed by PJM Interconnection, the regional grid operator responsible for maintaining reliability for 67 million people across 13 states and the District of Columbia. Reflecting nationwide – and even global – trends, PJM expects power demand to grow significantly in the coming years, with data centers playing a major role.

The latest results offer an early, market-based indicator of how the power sector is responding to rapidly growing demand, and where policy attention may be needed next.

PJM’s interim CEO David Mills emphasized that “These numbers represent significant interest from developers resulting from strong market signals, and our reformed process is designed to prioritize viable projects that can move to construction and operations with greater speed and certainty.”

A Surge in Applications Reflects Rising Demand

More than 800 projects—totaling roughly 220 gigawatts of potential capacity—have applied to connect under PJM’s newly reformed process.

This level of interest reflects strong market signals, driven by factors policymakers are already tracking closely: the rapid growth of data centers, increased electrification, and expanding domestic manufacturing.

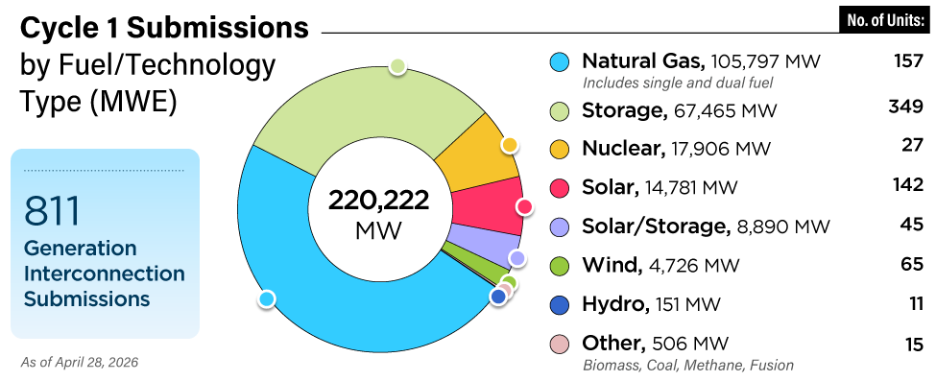

811 new generation projects, capable of generating 220 gigawatts of electricity, have applied to connect to the grid through the first Cycle of PJM’s reformed interconnection process. Credit: PJM Interconnection, April 2026

What’s in the Queue

The applications include a broad mix of resources: natural gas, energy storage, renewables, nuclear, and even a first-ever fusion project.

This diversity underscores a key point: competitive power markets are producing a wide range of commercially-viable potential solutions to hyperscalers, other customers, and grid operators to meet demand.

At the same time, the composition of the queue highlights an immediate reliability need. Natural gas (105.8 GW) and storage (66.5 GW) make up a significant share of proposed capacity, reflecting the importance of dispatchable resources—power sources that can run on demand—to support grid reliability and 24/7 energy needs, particularly from large users like data centers. Paired with renewables, storage and natural gas help ensure power is available when and where it’s needed.

What’s Needed to Move to Construction

PJM’s updated process is designed to address a major bottleneck. The shift to a “first-ready, first-served” system prioritizes projects that are more likely to move forward, aiming to reduce delays and improve certainty.

This is a notable step toward filtering out speculative projects and improving how quickly new supply can be evaluated and approved.

But clearing the interconnection queue does not guarantee a project will be built. Many projects that receive approval still face significant hurdles, including state and local permitting timelines, supply chain delays, equipment backlogs, and workforce constraints. These issues are increasingly central to conversations at the federal and state level.

These barriers are faced by competitive developers and vertically integrated utilities alike – no one market model is better suited to bring resources online more speedily. Addressing these barriers will help translate strong developer interest and private capital into real-world infrastructure that supports reliability and economic growth.

From Queue to Construction: the Policy Gap

Historically, only a portion of projects in the queue ultimately reach operation. Since 2020, PJM has processed more than 300 GW of projects, resulting in 103 GW of resources with signed interconnection agreements. But approximately 70 GW of those approved projects either withdrew their agreements, paused construction, or are otherwise delayed due to factors beyond the market’s control.

The gap between projects proposed and projects built is where policy decisions can have the greatest impact. EPSA continues to urge action on comprehensive permitting reform legislation, but has highlighted our support for promising areas for consensus such as the GRID Act sponsored by Ohio Representative Troy Balderson.

The strong response to PJM’s queue reopening shows that private investment is ready to support new generation. Ensuring those projects move forward will depend on aligning interconnection improvements with progress on permitting, infrastructure, and workforce development.

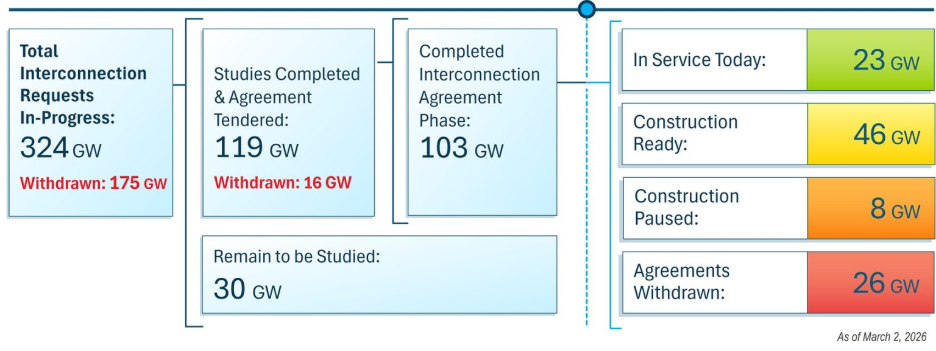

Approximately 70 GW of projects with interconnection queue agreements in PJM have not been constructed due to factors outside competitive power market design. Credit: PJM Interconnection, March 2026

Companies Are Innovating

EPSA member companies have shown innovative approaches to strike agreements with hyperscalers, turbine manufacturers, and construction firms to build new generation and expand existing power plant capacity, and to shore up access to both critical equipment like natural gas turbines and the workforce needed to bring new plants online in the timeframe required. Partnerships with AI companies like NVIDIA are also working to increase data center efficiency and flexibility to ramp up or down as grid reliability requires.

EPSA members have announced more than 12 GW of new capacity in PJM since mid-2024 through new builds, uprates, and delayed power plant retirements.

What’s Next

Not all of the projects submitting applications will eventually secure interconnection agreements and move to development. With the closing of the application window on April 27, PJM now begins a validation phase to confirm that projects have met the required technical and financial information to advance the process. Projects will be reviewed in what is designed to be a one- to two-year process, depending on the individual project’s impact.

The Bottom Line

While most of the increase in electricity costs over the past decade has been driven by utility spending on transmission and distribution infrastructure—not power generation or capacity market prices—bringing new generation online remains essential to addressing supply constraints and managing long-term consumer costs. Meeting rising data center demand through competitive electricity markets and private sector agreements will help ensure that American households and consumers don’t have to pay more than necessary for infrastructure growth.

The strong response to PJM’s queue reopening shows the market is stepping up, with a large and diverse set of proposed projects available to meet rising demand from hyperscalers and other energy users. Within that mix, reliable, on-demand resources will continue to play a critical role in maintaining grid reliability in the near term.

How much of this proposed supply ultimately comes online will depend on policy choices and addressing other challenges beyond the queue.

As demand growth accelerates, the speed at which new generation can move from application to operation will shape the reliability and affordability of electricity and America’s AI leadership and overall economic competitiveness.

Read more:

EPSA Welcomes New PJM CEO, Says Strong Power Markets Key to Delivering Reliable, Affordable Electricity
“Our Nation Is at an Inflection Point”: EPSA President & CEO Todd Snitchler Testifies on the State of the Bulk Power System
Power Markets 101: How Competition Keeps the Lights On — and Costs Down

Filed Under: Competitive Markets, Competitive Power Markets, Homepage Featured Article, Newsroom, PowerFacts Blog, Reliability, Rising Power Demand, State Policy, Uncategorized Tagged With: affordability, Competition, competitive markets, Demand, Electric Power Supply Association, energy policy, EPSA, interconnection queue, load growth, Permitting Reform, PJM, power generation, power markets, reliability

Primary Sidebar

  • Media Contacts
  • Press Releases
  • Power Moves Newsletter
  • Factsheets and White Papers
  • Opinion and Commentary
  • Social Media
  • Podcast

Share

Home Page Help Area

Sign up for EPSA’s Power Moves newsletter – a monthly update on the road to a reliable energy future that works for all Americans.

LEARN MORE

Footer

1401 New York Ave. NW
Suite 950
Washington, DC 20005

p 202.628.8200
f 202.628.8260

  • Facebook
  • LinkedIn
  • Twitter
  • Home
  • About EPSA
  • Filings
  • Newsroom
  • For Members
  • Contact
  • PowerFacts Blog
  • FAQ

Copyright © 2026
